The Leander Driveway Permit and Its Submittal Packet
A driveway in Leander requires a plan reviewed permit rather than a counter transaction, and the Type I residential submittal shows the street accessed, the driveway location and width, the curb radius, culvert type and size, utilities, easements and trees over eight caliper inches. We prepare and submit that packet as part of the job.
Why Silence From the City Counts as a Denial
Under Section 3.13.042, if no notice comes back within ten working days the applicant may assume the permit has been denied, which is the reverse of the deemed approval rule most people expect. We track that clock rather than reading silence as approval, because assuming a yes here is how a start date is lost.
The Construction Bond and the Cash Deposit
Every permit issued under Chapter 3 carries a bond or a cash deposit scaled to the estimated cost of construction, and it reaches ordinary residential work rather than only commercial projects. We identify the band your job falls into before you sign. We also carry the public liability and property damage insurance the city requires on bonded work.
Culvert Pipe and the Safety End On It
Where a driveway crosses a ditch, a culvert carries the flow and a safety end protects the exposed pipe, built to Leander standard details 202-2 and 202-3. Sizing follows the drainage, not the driveway width. We size and detail both in the submittal, because an undersized culvert is rejected at review or fails later.

Driveway Approaches, Aprons and the Two Percent Slope
Every approach carries a uniform two percent slope inside the right of way, and we build residential to COA 433S-1 and commercial to COA 433S-2 as drawn. Water standing at the street is the one defect the city makes a contractor rebuild at its own expense, so the slope is set and checked before the pour.
Driveway Connections in the Leander ETJ
In the Leander extraterritorial jurisdiction most city permits fall away, but a driveway connection remains one of the few still required. We confirm which side of that line a property sits on before starting. Assuming a rural address is unregulated is how an otherwise finished driveway ends up needing after-the-fact approval.
Site Development Permits and Commercial Concrete
Commercial work crosses into site development review, which brings drainage, paving sections and accessibility into the same submittal rather than treating them as separate jobs. We build commercial flatwork and paving to those approved plans, and we keep an updated contractor registration on file with Leander Building Permits and Inspection, which the city requires and charges nothing for.
Parking Lots, Curb and Gutter, Wheel Stops and Bollards
A parking lot is pavement, COA 430-2 reinforced curb and gutter, striping, wheel stops and bollards protecting what vehicles reach. We build the section and the protection together. Bollards added after a storefront has already been struck cost more than the ones designed into the original layout.

Accessible Routes, Curb Ramps and Barriers Review
An accessible route needs curb ramps, running and cross slopes within tolerance, and a detectable warning surface at the street, following PROWAG. Larger commercial projects also trigger TDLR architectural barriers review. We build to those tolerances and verify with a level, since a ramp a fraction out of range fails inspection and gets replaced.

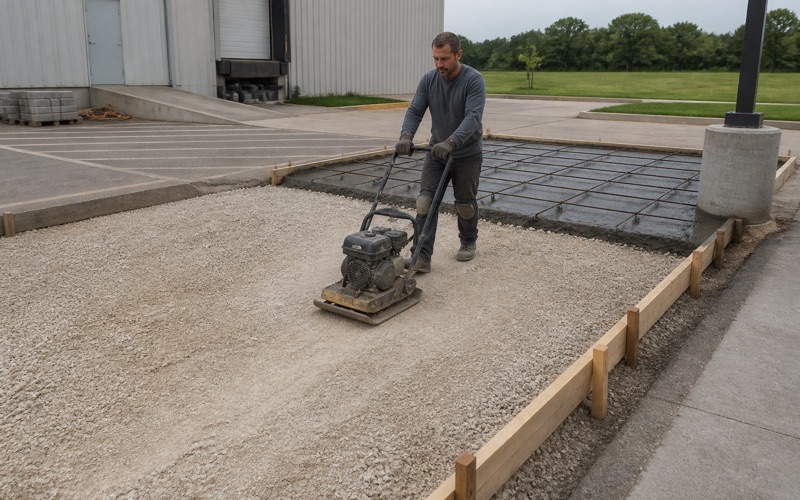

Dumpster Pads and Loading Areas
A dumpster pad takes a front-loading truck’s concentrated axle load and the abrasion of a steel container dragged across it, so it is a thicker, more heavily reinforced slab than the parking around it. We build pads and loading areas to that duty. A pad poured to lot thickness fails at the container corners first.
Concrete Work Kept to Approved Hours
We work the hours the approved plans allow, which means nothing overnight and nothing on a weekend without the inspector’s approval arranged four days ahead. On a commercial reconstruction we keep at least half the driveway open at all times. That is what the specification requires and what keeps your tenants trading while the work runs.
